|
|
Update: January 2006 |
|
Recommendations
Edinburgh Council announced on 19 January 06:
- Tomorrow, 20 January 06, the council will
issue a report on the proposed tram lines, to be discussed at a full
council meeting on 26 January 06.
- This report will state that, due to costs
having risen from £473m to
£714m, the
council is no longer able to afford the the whole of Lines 1 and 2 at this
stage, and it therefore recommends that the following should be
shelved:
- the western and northern parts of
Line 1, running from Leith via Granton to join Line 2 near
Haymarket.
- the eastern end of Line 2, linking
Edinburgh Airport and Newbridge.
|
|
Phase 1
This leaves just a single line, to be known as
Phase 1, from Ocean Terminal, Leith to Edinburgh Airport, to go ahead in
2010.

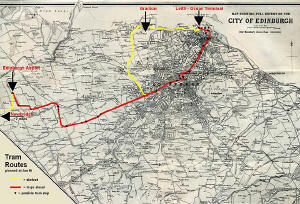

Please click on the map below to enlarge it.
©
|
|
Phase 2
The western part of Line 2, linking Princes
Street and Granton, through Edinburgh Waterfront, is to be known as Phase
2. This will be shelved unless the project can be delivered under
budget. The promoters still say that delivery under budget is
possible.
Please click on the picture below to see the land
that has already been prepared for Line 1, beside Waterfront Avenue to the
south-west of Granton Harbour.
©
Waterfront Avenue
|
|
Phase 3
The northern part of Line 2 linking Granton,
Newhaven and Leith is to be known as Phase 3.
|
|
Phase 4
The western end of Line 1, linking Edinburgh
Airport and Newbridge is to be known as Phase 4.
|
|
Edinburgh Evening News
January 19, 2006, pp.1,4 |
|
Update: January 2006 |
|
Costs
The cost
of the line for Phase 1, from Ocean Terminal to Edinburgh Airport is
estimated to be £484m.
The
funding expected from the Scottish Executive, if the tram bill is
passed in the Scottish Parliament, around March 2006, is expected to be
£490m.
In
addition, Edinburgh Council has raised £45m, mainly from taxes on land
close to the proposed lines. This gives a total of £529m and leaves
a surplus of £51m to be put towards Phase 2, the line linking Haymarket
and Granton.
|
|
Political Comments
Labour: "It is more important to have a 'core'
tram route in place as soon as possible" Donald
Anderson, Council Leader, supporting of the proposals
"We will complete all the lines in a phased
manner."
Andrew Burns, Transport Leader.
Green Party: "If the council cannot
provide public transport to get people out of their cars, then the future
of the redevelopment of Granton will be undermined."
Mark Ballard, Lothian Green MSP
Liberal Democrat: "Edinburgh has talked for
too long about a real effective mass transit link from the western suburbs
of Edinburgh and on to Leith. The council must act now or be
condemned for inaction by future generations"
Phil Wheeler, Liberal Democrat transport
spokesman.
SNP: "Trams were removed from Edinburgh for a
very good reason and the plans should be scrapped now.
Steve Cardownie, SNP Councillor
|
|
Edinburgh Evening News
January 20, 2006, pp.8,9 |
|
Update: February 2006 |
|
£500,000 for Badger Protection
Figures for the cost of protecting badgers on the
new tram routes have been released to the Evening News under the Freedom
of Information Act.
It is estimated that to protect badgers
from the trams, by creating a series of "safe runs" using bridges, tunnels
and fencing, could cost £540,000.
These costs include:
- £320,000 for 11km of fencing.
- £40,000 for a network of tunnels for the
badgers.
- £20,000 for re-housing the badgers while
the line is being built.
- £85,000 for wildlife experts who will
monitor the workers and the badgers!
Badgers are a legally protected species. It
is estimated that about 35 badgers live close to the proposed track
- four families near Edinburgh Airport and two families in the
Roseburn Urban Wildlife Corridor on the route between Haymarket and
Granton.
|
|
Edinburgh Evening News
February 2, 2006, p.5 |
|
Update: February 2006 |
|
Scottish Parliament Debate
Members
of the Scottish Parliament's Edinburgh Trams (Line One) Committee
are due to question Edinburgh Council leader, Donald Anderson, and TIE
leader, Michael Howell, tomorrow.
Edinburgh Council announced on January 19 that Phase 1 of the system would
provide only one line, from Leith to Edinburgh Waterfront. However,
MSPs are likely to demand that the trams serve the Waterfront population
which includes areas near Newhaven and Granton.
The article comments that Edinburgh Waterfront's
population is going to be the equivalent of the population of Perth,
Scotland. |
|
Edinburgh Evening News
February 6, 2006, p.17 |
|
Update: February 2006 |
|
Tendering for Trams
TIE have selected four companies from 11 who
applied to tender for the design and supply of trams to Edinburgh.
The final choice is expected to be made during 2006.
The four
companies currently bidding are:
- from Germany: Bombardier and
Siemens
- from France: Alstom
- from Spain: CAF
Edinburgh will require the trams to accommodate at least 200 passengers,
have low level boarding, CCTV cameras, real time information
displays and public address systems.
|
|
Edinburgh Evening News
February 28, 2006, p.7 |
|
Update: March 2006 |
|
Parliamentary Committee approve Trams
After
two years' consideration, and listening to many objections, Members
of the Scottish Parliament's Edinburgh Trams (Line One) Committee
have now approved the route proposed by Edinburgh Council.
The line
will use the Roseburn corridor, rather than pass directly past the Western
General Hospital. A shuttle bus service will be provided to from the
tram route to the hospital.
The
Parliamentary Committee expressed disappointment that funding problems had
resulted in shelving part of the proposed route and said that it was
"essential" for the section from Haymarket to Granton (coloured yellow on
the map below) to be built as soon as possible.
The
committee ruled that construction work should not take place on Saturday
afternoons in order to lessen disruption to shoppers and traders.
The trams are now scheduled to be operational by July 2010, but might the
shorter hours for construction result in further delays?
Please click on the map below to enlarge it.

All MSPs
will vote on the Bills for the two tram lines later in March 2006.
They will be recommended by their Parliamentary Committees to vote in
favour of the routes proposed by Edinburgh Council, even though it will
not be possible to build these routes in their entirety, initially.
|
|
Edinburgh Evening News
March 1, 2006, p.2 |
|
Update: March 2006 |
|
Parliamentary Vote
The
Scottish Parliament debated Tramline 2, the line to Edinburgh Airport, on
March 22..
David
Letchie, former Tory Leader and Kenny MacAskill, Scottish National
MSP questioned the business case for the line, but Sarah Boyack, Central
Edinburgh MSP and former Transport Minister spoke out strongly in favour
of the line.
MSPs
voted 88 to 20 in favour of the Bill for the tramline to go ahead.
They are
due to debate Tramline 1 next week, on March 29, 2006. |
|
Edinburgh Evening News
March 23 2006, p.8 |
|
Update: March 2006 |
|
Funding and Delay
After
studying a detailed audit of all the Scottish Executive's major transport
commitments, Tavish Scott, Transport Minister in the Scottish Parliament
has confirmed the parliament's support for these projects.
He
confirmed that the Scottish Parliament had agreed that funding for the trams will be increased to take account of
inflation, so increasing the Scottish
Executive's contribution from £375m to £450-500m for the tram line from
Edinburgh Airport to Ocean Terminal. (I thought the funding would have
been for the line from Edinburgh Airport to Newhaven.)
However,
he now estimates that the new tram system will not be operational until
early 2011. The previous estimate was July 2010. |
|
Other Edinburgh Transport Proposals
Tavish
Scott also gave these estimates for other transport proposals:
-
Rail Link to Edinburgh Airport - now expected to open in
2011
(1 year later than expected).
-
Waverley
Line to the Borders - now expected to re-open in 2011
(3 years later than expected).
-
Waverley Station improvements, phase 1: expected 2007 (on time).
|
|
Edinburgh Evening News
March 16, 2006, p.11 |
|
Update: March 2006 |
|
Initial Spending
TIE say
that by Autumn 2006 between £50m and £60m will have been spent on the
Tramline proposals, including £23.5m on consultant fees.
Despite
the Scottish Parliament having given their approval, concern over costs
continues to be expressed in the columns of the Edinburgh Evening News.
Yellow ribbons have been tied to trees in the Roseburn Corridor as a mark
of protest. |
|
Timetable
The
timetable, now, at March 2006 is:
|
May 2006
|
Parliamentary
Bills to be passed. |
|
Summer 2006 |
Tenders for
construction of the tramlines. |
|
Summer 2006 |
Traffic
Management Plan to be drawn up. |
|
Sept 2006 |
Councillors
consider the final business case and decide whether to go ahead. |
|
Autumn 2006 |
Business Case
presented to Scottish Executive. |
|
Dec 2006/Jan
2007 |
Gas pipes and
water mains to be moved. |
|
Autumn 2007 |
Laying of
tram lines begins. |
|
Early 2010 |
Testing of
trams on the network |
|
1 July 2010 |
First day of
operation |
|
2015 |
Further
phases of network completed. |
|
|
Edinburgh Evening News
March 30, 2006, pp.6-7 |
|
Update: May 2006 |
|
Trams Boss leaves
It was
announced on May 9 that Ian Kendall, Head of the Edinburgh Trams project,
has had his contract terminated amid fears that there may be further
delays in the scheme and that TIE may miss the Autumn 2006 deadline for
presenting a business case to the Ministers of the Scottish Parliament.
Ian
Kendall is an Australian who has managed previous team bids including
Manchester, Leeds and the London borough of Croydon. He was never
formerly employed by TIE but had a contract with TIE in the name of his
own management company.
TIE
Chief Executive, Michael Howell has now taken temporary control of the
project. He claims that the project is still on schedule to meet the
2010 deadline for operation.
Edinburgh Evening News
May, 2006 |
|
Ian Kendall has been replaced by Andie Harper, a
former director of London Underground who saw the completion of the London
Underground's Jubilee Line.
However, Ian Kendall is also being retained by
TIE as a private consultant for at least the next 3 to 6 months.
Edinburgh Evening News
May 25, 2006: p.9
Edinburgh Evening News
June 14, 2006, pp.1-2 |
|
Update: June 2006 |
|
Chairman leaves
A second
high profile departure from TIE has been announced.
Michael
Howard, Chief Executive of TIE is to leave in July 2006 and to move to
London to become Chairman of the City & Guilds of London Institute.
Willie
Gallagher, who was appointed TIE Chairman in early June 06, is to take on
most of Michael Howard's duties.
The TIE
project has continued to have problems, missed deadlines and technical
design problems, but Michael Howell claims: "Things are in good shape."
Edinburgh Evening News June
14, 2006, pp.1-2 |
|
Two
further departures from TIE have been announced.
Project Director, Alex Macauley, is expected to
leave and Assistant Project Director, Willie Fraser has resigned for
personal reasons.
However,
Edinburgh Council leader, Donald Anderson, remained optimistic saying:
"I am very confident TIE and the council are in a much better position to
deliver the project than ever before."
Edinburgh Evening News
June 16, 2006, p.6 |
|
New Chairman's Comments
Shortly after taking up his appointment as TIE
Chairman, Willie Gallagher spoke to the Edinburgh Evening News:
Here are some extracts from Willie Gallagher
comments to the News:
- TIMESCALE: "We will make that deadline
(June 2010). There's a lot of key events to hit in the next few
months"
- ROUTE CUTBACKS: "What we have now is a
sensible route, the characteristics of which support the wider rail
transport network. It operates where you have high volumes of people
wanting to move to parts of the city to work or visit."
- POSSIBLE FURTHER ROUTE CUTS: "At
this point we are going with the route that everyone is aware of. If
there are parts of the system where the costs don't recognise the
benefits, then that would have to be looked at.
Truthfully, I don't see the Airport to
Newbridge section happening. We are gung ho about all the rest and
are pushing hard."
Will we ever build a Newbridge link or a link
between Granton and Leith? I think, no because if we had the money
to do it, then there are other bits - such as the Western General Hospital
link that we would do first."
Edinburgh Evening News
June 23, 2006: pp18-19 |
|
Update: September 2006 |
|
Construction Delays
Work to
remove gas pipes and water mains along the routes of the trams was
expected to begin in January 2006 but has now been put back until at least
March or April 2007, due to delays in drawing up contracts.
There is
concern that the work may be delayed until after the Local Council
Elections in May 2007. Digging up roads would be likely to result in
disruption and congestion, which would be unpopular with voters.
TIE
confirmed that the first trams are now expected to carry passengers in
2011, with the first trams being tested from early 2010 onwards.
Edinburgh Evening News: Sep 29, 2006, p5
AND Herald & Post, October 5, 2006, p9 |
|
Update: September 2006 |
|
Advertising Campaign
TIE has
launched a £100,000 advertising campaign to "win the hearts and minds"
of the Edinburgh public. There will be advertising in newspapers, on
the radio and on buses and bus shelters with the message:
"It's Time For Trams."
Edinburgh Evening News: Sep 29, 2006, p5 |
|
Update: November 2006 |
|
Business Case
Edinburgh Transport Forum is to host a public meeting on trams on November
29, 2006.
A
business case is being developed for the trams, to be voted on by the City
of Edinburgh Council on December 22, 2006, then submitted to the Scottish
Parliament for approval of funding.
By
Christmas 2006, it is expected that £62m will already have been spent on
the proposals for Tram Lines One and Two.
The
design detail for the project will not become available until January 2007
at the earliest.
Edinburgh Evening News
November 28, 2006, p12 |
|
Update: November 2006 |
|
Project Director leaves
After
only six months in his position as Project Director, Andie Harper,
formerly of London Underground, has decided not to renew his contract with
TIE, for personal reasons - difficulty in commuting between Warrington and
Edinburgh
He will be the 4th senior person to have left the
project this year.
- May 9, 2006: Ian
Kendall, Project chief.
- Jun, 2006:
Michael Howell, Chief Executive.
- Dec 22, 2006: Andie Harper, Project
chief.
Edinburgh Evening News
November 29, 2006, p5 |
|
Update: December 2006 |
|
Tram Line 3 - Guided Busway
Tram
Line 3, from the City Centre to Newcraighall, via Cameron Toll and the
Edinburgh Royal Infirmary at Little France was shelved indefinitely when
the Council's proposals for congestion charges were defeated in the
referendum of April 2005.
However,
the Council has now announced a feasibility study into a guided busway
along the land already safeguarded for Tramline 3 between Cameron Toll and
the ERI. This could be the first step towards the council long-term
wish to create Tram Line 3.
The
feasibility study is not likely to be completed before 2008.
Edinburgh Evening News
November 29, 2006, p5 |
|
Update: December 2006 |
|
Charities support Tram Lines
Eleven
charities and conservation organisations have now come out in support of
trams for Edinburgh, and are encouraging Edinburgh Councillors to vote in
favour of the proposals on December 21, 2006
They
favour trams on the grounds that they will be less polluting and better
for the environment than buses.
The organisations concerned are:
- Capability Scotland
- The Cockburn Association
- Friends of the Earth Scotland
- National Trust for Scotland
- RSPB, Scotland
- Scottish Association for Public Transport
- Scottish Environment LINK
- Stop Climate Chaos
- TRANSform Scotland
- Voluntary Health Scotland
- WWF Scotland
Edinburgh Evening News
December 16, 2006, p2 |
|
Update: December 2006 |
|
Compensation to Shops
Following lengthy negotiations between TIE and the Edinburgh Chamber of
Commerce, it has been announced that shops that see their profits fall as
a result of disruption caused by preparations for Edinburgh's trams, will
be given cuts of up to 80% in their business rates.
Edinburgh Evening News
December 20, 2006, p19. |
|
Update: December 2006 |
|
Businesses support Tram Lines
Seventeen organisations including some of Scotland's largest businesses
have signed a letter to be sent to all councillors, urging them to back
the proposals for new tram lines at their meeting on December 21, 2006.
The organisations include:
- Standard Life
- Scottish Widows
- Marks & Spencer
- Oracle
- Edinburgh Airport
- Forth Ports Authority
- Edinburgh International Conference Centre
- Edinburgh University
- Heriot Watt University
- Telford College
It is expected that:
- Tram Line 1, from Leith to Edinburgh
Airport will open in December 2020
- Tram Line 2 to Edinburgh Waterfront will
open one year later.
Edinburgh Evening News
December 19, 2006, p17 |
|
Update: December 2006 |
|
Council Votes 'Yes'
Edinburgh Councillors at their Meeting on December 21 overwhelmingly
supported the business case to be submitted to the Scottish
Parliament in favour of re-introducing trams to Edinburgh.
Only one councillor, Deputy Lord Provost Steve
Cardownie (Nationalist) voted against the proposals. Kate Mackenzie
(Conservative) abstained.
Edinburgh Evening News
December 22, 2006, p5 |
|
Update:
January 2007 |
|
New Appointment
Matthew Crosse has been appointed to take charge
of the Edinburgh trams project, replacing Andrew Harper who left in 2006.
Matthew Cross is founder of independent
management consultancy 'Strategic Lines' based in Derbyshire, and has
worked on several tram schemes in the UK including Nottingham, Croydon and
Midland Metro.
Edinburgh Evening News January 16, 2007: p.9 |
|
Update:
March 2007 |
|
Draft Business Case Approved
The Scottish Executive has its given its approval
in principle to the draft business plan for Edinburgh's trams. A
final business case will be assessed in the autumn
It has also been confirmed that those over age 60
and the disabled will be able to travel free on the trams.
Work to Begin
Work will to begin on diverting the water, gas
and electricity pipes away from the proposed tram route. The first
street to be dug up, as a trial site, will be Tower Place, Leith,
beginning on April 2, 2007. Work on this section of the line will
stop over the Easter holidays and should be completed by mid-May 2007.
City Leader, Ewen Aitken said:
"We've been talking about and preparing for
trams for years. But now is the time to make it a reality and
actually start work on the ground.
I promised that we wouldn't let the small
matter of an election get in the way of this important project and we've
delivered on that."
It is estimated that the tram line between Leith
and Edinburgh Airport will be completed by Christmas 2010.
Edinburgh Evening News March 16, 2007: p.2
Edinburgh Evening News March 31, 2007: p.6
|
|
Update:
April 2007 |
|
Lack of Support
Local and Scottish Parliament elections are due
to be held on May 3, 2007.
Ahead of these elections, Mike Graham of radio
station 'Talk 107' hosted a pre-election debate before an
all-ticket audience of 250.
The 'Evening News' reported that transport
issues were high on the agenda.
Labour, Lib Dem, Tory and Green
politicians all spoke in favour of the trams; SNP's Steve Cardownie was a
lone voice in opposition. However, in the audience, less than
a third of those present supported the proposed tram scheme.
Edinburgh Evening News April 18, 2007: pp.10-11 |
|
Update:
April 2007 |
|
Tunnel Problems
The 'Evening News' reported that the
extent of the network of tunnels beneath the roads between Leith and
Haymarket has taken engineers by surprise.
These tunnels about 3 ft wide, 6 ft high, were
built to enable mechanics to service the cables that hauled cable cars
through the streets of Edinburgh. Cable cars operated in Edinburgh
between 1888 and 1923.in the early 1900s.
Edinburgh Evening News April 19, 2007: p.9 |
|
Update:
May 2007 |
|
Scottish Parliament Elections
The
Scottish National Party emerged as the leading party with 47 seats, but
not an overall majority in the Scottish Parliament elections held on May
3, 2007.
| |
